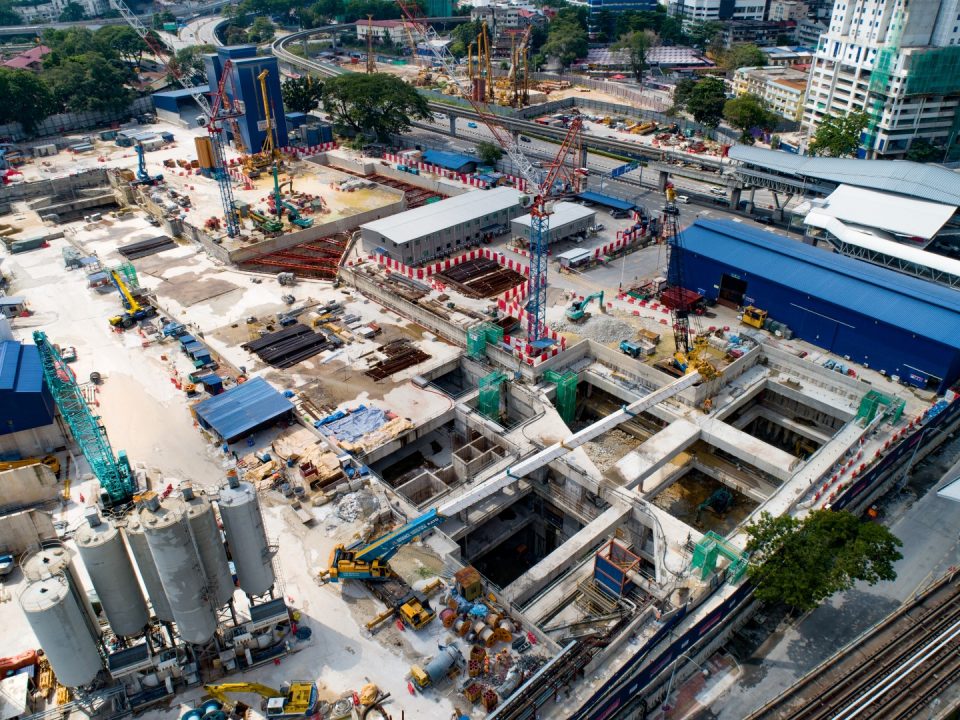

March 31, 2020
Pandangan udara tapak pembinaan Stesen MRT Titiwangsa.

Jalan Tun Razak (Titiwangsa)

Aerial view of the Titiwangsa MRT Station construction site.
March 31, 2020

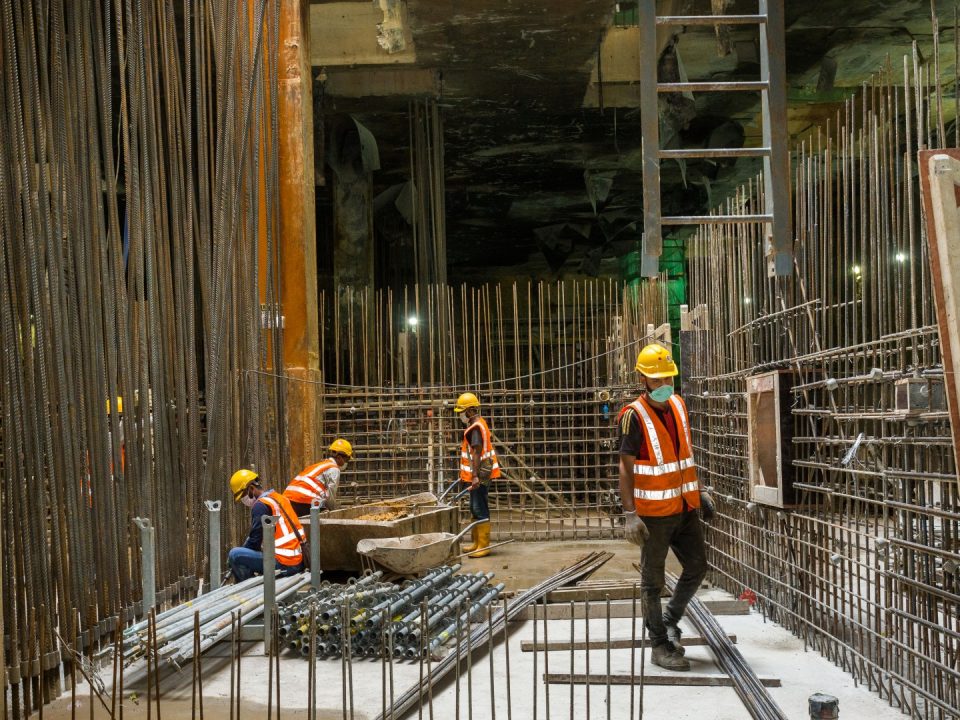

Pandangan udara tapak Stesen MRT Hospital Kuala Lumpur menunjukkan kerja-kerja memasang siap di lengkungan bar untuk kerja-kerja pengukuhan konkrit stesen di papak bilik loji dan papak asas.

Jalan Tun Razak (Hospital Kuala Lumpur)

Aerial view of the Hospital Kuala Lumpur MRT Station site showing the fabrication works at bar bending yard for station reinforcement concrete works at plantroom slab and base slab.
March 31, 2020

Pemasangan bar pengukuhan untuk pembinaan bawah tanah dan pengukuhan papak konkrit di aras ruang legar Stesen MRT Raja Uda

Jalan Raja Muda Abdul Aziz (Raja Uda)

Installation of reinforcement bar for underground construction and reinforcement concrete slab at Raja Uda MRT Station concourse level
March 31, 2020

Pemasangan pratuang dinding dalaman di aras bawah tanah 6 Syaf Kecemasan 2

Jalan Gurney (Escape Shaft 2)

Installation of precast internal wall at lower ground level 6 of the Escape Shaft 2.
March 31, 2020

Pembinaan pengukuhan dinding konkrit di aras platform atas Stesen MRT Ampang Park.

Jalan Tun Razak (Ampang Park)

Reinforcement concrete wall construction at Ampang Park MRT Station upper platform level.
March 31, 2020

Pemasangan rebar dan pemasangan kerja acuan dinding dalaman konkrit tetulang di aras ruang legar Stesen MRT Persiaran KLCC

Jalan Binjai (Persiaran KLCC)

Rebar installation and formwork installation of reinforced concrete internal walls at Persiaran KLCC MRT Station concourse level.

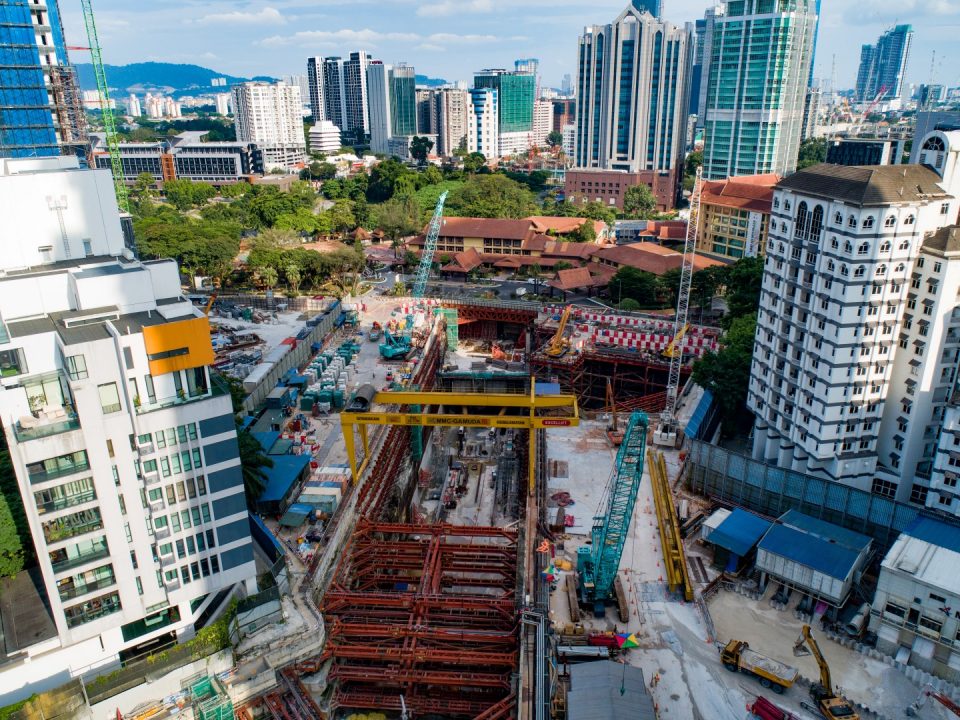

March 31, 2020
Pandangan udara Stesen MRT Conlay yang sudah 60.52% siap.

Jalan Conlay (Conlay)

Aerial view of the Conlay MRT Station with completion at 60.52%.
March 31, 2020

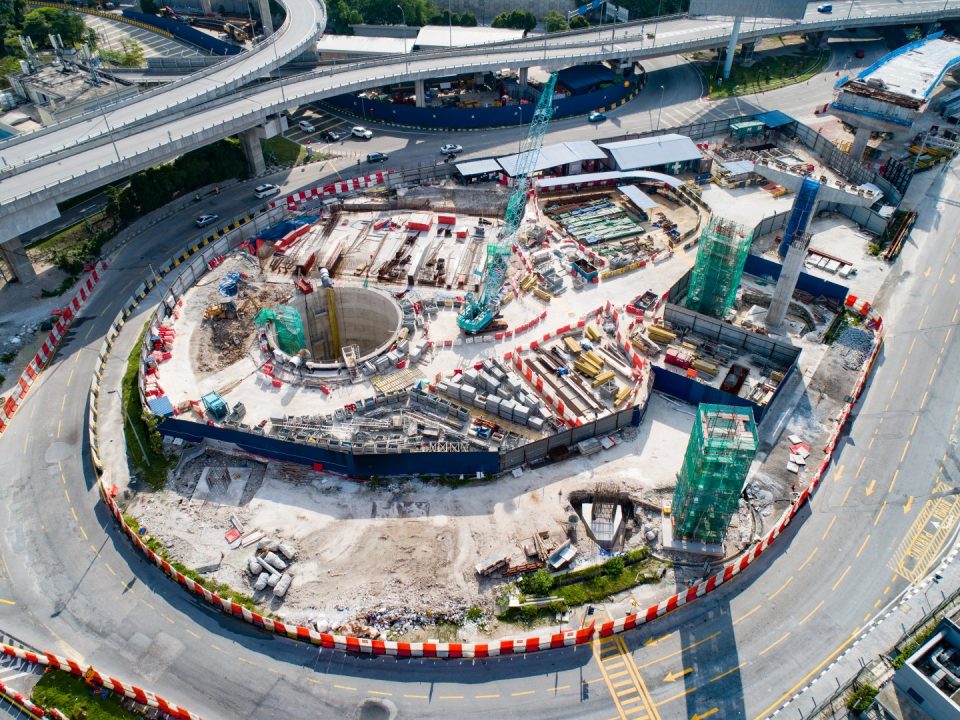

Pembinaan papak tengah aras bawah tanah B3 Syaf Penyelenggaraan 2, yang berada 15m di bawah permukaan tanah.

Kampung Pandan Roundabout (Intervention Shaft 2)

Construction of Intervention Shaft 2 basement level B3 intermediate slab which is 15m below ground level.
March 31, 2020

Jalan Peel (Escape Shaft 3)

Aerial view of the Escape Shaft 3 with completion at 72.25%.
